Job Cost Tracking Template: How to Monitor Labor and Material Expenses

Job Cost Tracking Template: How to Monitor Labor and Material Expenses

A profitable project on paper often turns into a loss leader once the last tool is packed away. The disconnect usually lies in the gap between the initial estimate and the actual consumption of labor hours and physical materials on site.

Precise job cost tracking functions as the necessary feedback loop to close that gap permanently. The method requires a shift from looking at overall company revenue to scrutinizing the specific inputs of a single work order.

By isolating every dollar spent on wages and every bolt purchased for a specific client, you gain the visibility to protect your margins. This practice transforms raw financial data into a strategic tool, allowing you to identify exactly which types of projects generate true value and which merely create the illusion of work.

Download the Free Job Cost Tracking Template (PDF)

Use this ready-to-use job cost tracking template to monitor labor and material expenses and keep your project budget on track.

Download the Free PDF Template

What Job Costing Actually Means for Your Work

Job costing is the practice of assigning every single expense to a specific project rather than letting it disappear into a general ledger. It provides a granular view of where resources are consumed, which allows for precise margin control on a per-client basis.

This approach isolates the financial performance of individual work orders to reveal their true profitability.

It Is Not General Accounting

General accounting shows the health of the entire company at the end of a fiscal period. Job costing, in contrast, focuses on the microeconomics of a single project from start to finish.

  • Bank statements only show a total withdrawal from an ATM or a lump sum paid to a supplier.
  • A job cost record shows that specific withdrawal paid for framing lumber delivered to the Smith residence.
  • General profit and loss statements combine revenue from all jobs, which can mask a failing project with successful ones.

The Focus on Labor as a Direct Cost

Labor is often the most variable expense on a job site and the hardest to track accurately. Job costing treats worker hours as a direct line item that must be reconciled against the project budget.

  • It requires logging the exact hours each tradesperson spends on a specific task.
  • It accounts for the burden rate attached to those hours, including taxes and insurance.
  • It compares actual hours worked against the estimated hours that formed the basis of the bid.

The Focus on Materials as Assigned Assets

Materials can leak profit if they are purchased for one job but used on another without proper documentation. Accurate job costing assigns material costs at the point of purchase or the point of use.

  • Receipts are coded to a specific job number at the checkout counter.
  • Returns or unused stock are credited back to the same job to adjust the final cost.
  • Bulk purchases allocated across multiple projects require a logical split to ensure each bears its fair share.

The Core Parts of a Useful Tracking Template

A template functions as a container for the raw data generated by a project. Its structure must capture the essential financial inputs without becoming so complex that it discourages regular use.

The design should prioritize fields that directly answer the question of whether a job was made or lost money.

The Job Header for Context

This top portion of the template establishes the scope and financial target for the project. It provides the baseline against which all actual costs are measured.

  • The header typically contains the client name and a unique project identifier for sorting and filing.
  • It also holds the original contract price or bid amount, which serves as the ceiling for all subsequent cost entries.
  • The physical location of the job and the project manager’s name are useful for quick reference.

The Labor Capture Area

This section is designed to translate worker hours into a monetary value that can be subtracted from the project revenue. It requires fields that log both time and the cost of that time.

  • Each entry should include the date work was performed and the name or initials of the worker.
  • The number of hours worked and the specific hourly rate for that employee or subcontractor are required to calculate the line total.
  • A column for the specific task performed, such as rough-in or trim-out, can help identify which phases ran over budget.

The Material Purchase Log

This part of the template acts as a ledger for every physical item that becomes part of the project. It moves material costs from a supplier invoice into the job-specific financial picture.

  • The log needs a field for the purchase date and the name of the supplier or vendor.
  • A description of the items, from lumber to fixtures, must be clear enough to identify what was bought.
  • The quantity, unit price, and final line total for the receipt are the core data points.
  • A column for the purchase order number or receipt number helps with audits and verifying duplicate entries.

The Change Order Tracker

Unforeseen work is a common source of budget variance that must be isolated from the original scope. This section captures additional client requests and their associated costs.

  • It should list a description of the extra work performed and the date it was authorized.
  • The additional labor hours and materials required for the change need their own rows.
  • A field for the additional fee charged to the client ensures this section ties back to an increase in the project’s total revenue.

How to Track Labor Without Making It Complicated

Labor tracking often fails because the system is too burdensome for the people expected to use it. The goal is to capture accurate time data with minimal friction, ensuring compliance from the crew.

A simple method applied consistently will always outperform a complex one that gets abandoned.

Use a Daily Field Log

Waiting until the end of the week to record hours relies on memory, which is often inaccurate. A daily log captures data while it is still fresh and can be completed in minutes.

  • A paper time card kept in the truck allows workers to note start and stop times immediately.
  • A shared digital spreadsheet on a mobile device can sync data to the office in real time.
  • The log should require a signature from the worker or foreman to verify accuracy before submission.

Calculate the True Hourly Cost

The hourly rate paid to a worker is not the full expense of having them on site. Payroll taxes, workers compensation insurance, and paid time off all add to the actual cost.

Cost ComponentDescription
Base Hourly WageThe gross pay rate agreed upon with the employee.
Payroll TaxesThe employer portion of Social Security, Medicare, and unemployment taxes.
Insurance BurdenThe premium for workers compensation, often calculated per hundred dollars of payroll.
BenefitsThe hourly cost of health insurance contributions or retirement plan matches.
Total Burden RateThe base wage plus all additional costs, expressed as a single hourly figure.

Assign a Rate for Solo Operators

A sole proprietor who does not take an hourly wage still needs to account for their time. The template requires a consistent value for owner labor to calculate true project cost.

  • The rate should be set at what it would cost to hire a qualified replacement for the same task.
  • This amount covers the owner’s skill and ensures the project bid includes a wage component.
  • It also prevents the owner’s labor from subsidizing a job that should have been priced higher.

How to Track Materials Without Losing Receipts

Material costs represent a significant portion of project expense and are prone to leakage through lost paperwork or poor allocation. A systematic approach to capturing these costs at the point of purchase is required to maintain an accurate job cost record.

The method should create a clear chain from the supplier transaction to the specific project ledger.

Establish a Digital Receipt Habit

Paper receipts fade, get left at the counter, or disappear in a truck cab before they reach the office. A digital capture routine creates an immediate backup and allows for quick entry into the template.

  • A dedicated mobile app or the camera on a phone can capture the receipt image at the checkout counter.
  • The digital file should be named with the job number and the date of purchase for easy retrieval.
  • A shared folder on a cloud service allows the office staff to access receipts for entry without waiting for physical handoff.

Organize Materials by Project Phase

Larger jobs often involve multiple material deliveries spread over several weeks or months. Grouping these purchases by the project phase provides better visibility into where the budget is being consumed.

  • Framing materials are logged separately from finish hardware or landscaping supplies.
  • Overages or restocking fees from a specific phase are attributed to that phase for accurate analysis.
  • This organization helps identify if the rough-in phase consistently runs over budget compared to the final trim-out.

Account for Small Balance Items

Incidental purchases like fasteners, adhesive tubes, or safety supplies are easily overlooked. These small-ticket items can accumulate to a significant sum over the life of a project.

Item TypeTracking MethodCommon Mistake
Bulk ConsumablesProrate across active jobs based on estimated usageCharging the entire box of screws to the first job
Trip SuppliesLog the full receipt to the job that prompted the runForgetting to include the gas can or the caulk gun
Rental EquipmentAssign the daily rate for the exact dates on siteLeaving the rental on the template after equipment return
Delivery FeesAdd the freight charge to the material line itemTreating delivery as a separate overhead cost

Putting It All Together: The Simple Math

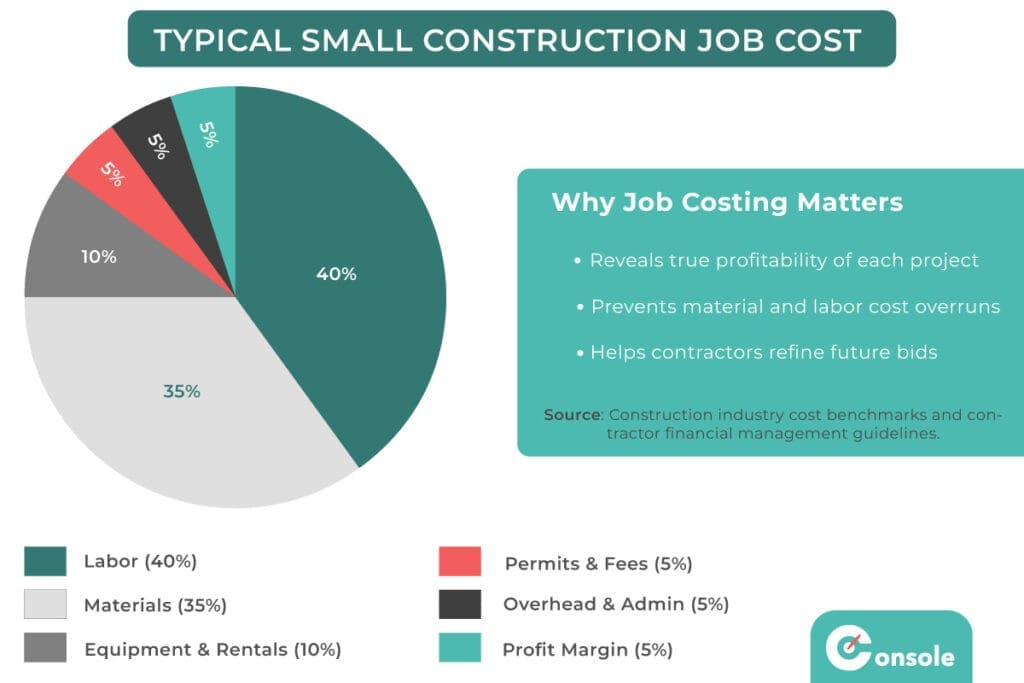

TYPICAL SMALL CONSTRUCTION JOB COST

Once labor and material data populates the template, the individual entries must be synthesized into a final figure. This calculation strips away the detail to reveal the project’s financial outcome.

The process is a straightforward subtraction problem that provides a clear yes or no answer on profitability.

The Basic Formula

The relationship between revenue and expense governs the success of any project. The template organizes these elements to perform a simple calculation.

  • Total Labor Cost is the sum of all wages, burden, and subcontractor payments entered in the labor section.
  • Total Material Cost is the sum of all purchases, delivery fees, and rental charges logged in the materials section.
  • Total Job Cost is the sum of labor and materials combined.
  • Gross Profit is the Original Contract Price minus the Total Job Cost.

Compare Against the Original Bid

The final calculated cost holds little value in isolation. It must be placed next to the number that started the project, which is the estimate or bid amount.

  • A positive result after subtracting costs from the contract price confirms the project generated value.
  • A negative result, or a profit margin thinner than anticipated, signals a flaw in the estimating process or the execution.
  • The variance between the bid and the actual cost becomes the primary metric for improvement on future projects.

Identify the Specific Variance

A simple profit or loss figure does not explain what went wrong. The template allows for a deeper look into the components of the variance.

Variance TypeWhat It Looks LikeWhat It Suggests
Labor OverageActual hours exceed estimated hours by a significant marginThe task took longer than expected or the crew efficiency was low
Material OveragePurchase totals exceed material takeoff estimatesWaste was higher than planned or prices increased after the bid
Scope CreepCosts appear for work not described in the original contractChange orders were not documented or approved before execution
Pricing ErrorThe final cost aligns with the estimate but the profit is lowThe initial bid price was too low for the required work

Job Cost Tracking Software: How to Monitor Labor and Material Expenses

The practice of tracking labor and materials against a specific project removes guesswork from financial management. It provides a clear verdict on every job, showing whether the work performed generated value or consumed resources without adequate compensation.

A manual template serves this function effectively for many operations, creating a structured record of every hour worked and every screw purchased. The same principles of allocation, burden calculation, and variance analysis apply regardless of whether the data is kept in a spreadsheet or a dedicated platform.

For operations seeking to automate the capture process and reduce manual entry errors, dedicated job cost software offers a natural progression. These platforms can integrate with payroll systems to pull labor hours directly and with supplier accounts to import material receipts.
